Osborne Street Bridge Rehabilitation Project
This project is now complete.
Traffic Management Plan
A similar traffic management plan to that successfully implemented in Phase 1 is planned. From late March to late August 2012, there will be two southbound traffic lanes and one northbound lane, except for morning rush hour when one lane will be reversed, making two northbound lanes and one southbound lane.
Traffic Management Plan during Construction

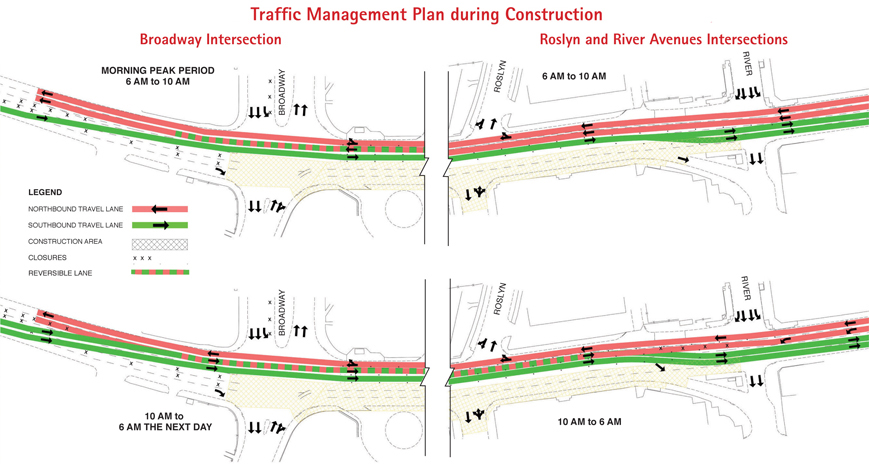

Late April to late June 2012
(Late March to late April and Late June to late August similar) |
|
Select image for larger version |
Measures to aid traffic flow and safety include
Late March to late April and late June to late August:
- No left turns onto Roslyn Road from Osborne Street in either direction.
- Right turns for Osborne Street southbound traffic permitted at Mostyn.
- Left turns for northbound Osborne Street traffic permitted at Broadway.
- Left turns from northbound Osborne Street traffic onto Mostyn permitted for emergency vehicles only.
- Transit stops remain at existing locations.
- No diamond lane for southbound traffic on Osborne Street.
Late April to late June:
- No left turns onto Roslyn Road from Osborne Street in either direction.
- No traffic permitted on Mostyn except emergency vehicles.
- No northbound left turn from Osborne Street onto Broadway.
- Bus stops for northbound and southbound Osborne in front of the Great West Life Building will be removed.
- No diamond lane for southbound traffic on Osborne.
- Direct access maintained for Great West Life and Shell gas station.
|
|
Beginning in late August to mid-October, two lanes will be available for both northbound and southbound traffic and left turns for northbound traffic will be permitted at Broadway. Traffic restrictions will continue on Mostyn, the diamond lane for southbound traffic on Osborne will not be in effect and Transit stops will return to existing locations. |
Traffic Management Plan during Construction
Late August to Late October 2012 |
Select image for larger version |
Pedestrian and Cyclist Access
The east sidewalk over the bridge will stay open throughout construction. Pedestrian and cyclist access and crossings will be clearly signed as they are adjusted during construction.
Pedestrian and cyclist traffic crossing Osborne Street north of the bridge can use the signalized crossing at Broadway Avenue or the underbridge crossing on the north bank of the river, when it is available. In 2011, the underbridge crossing level was raised as high as possible to prevent closing during high water levels of the Assiniboine River. The crossing has a roof for protection from construction debris.
Street-level at Assiniboine Avenue and Mostyn Place is a construction zone, and is unsafe for pedestrians. The signalized crossing for pedestrians and cyclists will be operational once construction concludes and sidewalks are completed.
Below are PDF maps showing access for pedestrians and cyclists during construction:
